Rocky_Branch_Open_Trench

Water and Sewer

State Street Water and Sewer Improvements Phase 3A

Upgrading downtown infrastructure

Construction is underway in downtown Raleigh to replace and upgrade aging water and sewer lines. This work is happening ahead of Bus Rapid Transit (BRT) construction in the area to avoid digging up the streets again later. Crews will replace or rehab nearly 2 miles of underground pipes across six downtown streets. Work is expected to finish Summer 2026.

Benefits

  • Replaces aging water and sewer lines
  • Prepares streets for future Bus Rapid Transit (BRT) projects
  • Supports growth and reliability for years to come

Traffic Impacts

We know temporary lane closures and parking restrictions are not ideal for those who live, work, and play downtown. But replacing aging infrastructure now helps prevent emergency pipe breaks later, which would be a much bigger disruption.

Upcoming Nighttime Street Closure – E Martin Street

The City of Raleigh will be making important improvements to E Martin Street as part of a planned capital improvement project.

What to expect:

  • Location: 100 block of E Martin Street (between S Wilmington Street and S Blount Street)
  • Dates: Sunday, January 4 through Friday, January 9, 2026
  • Time: Nightly from 7:00 PM to 6:00 AM

During these overnight hours, this section of E Martin Street will be closed to general traffic.
Bus traffic only will be permitted to access E Martin Street for entry to and exit from the bus station.

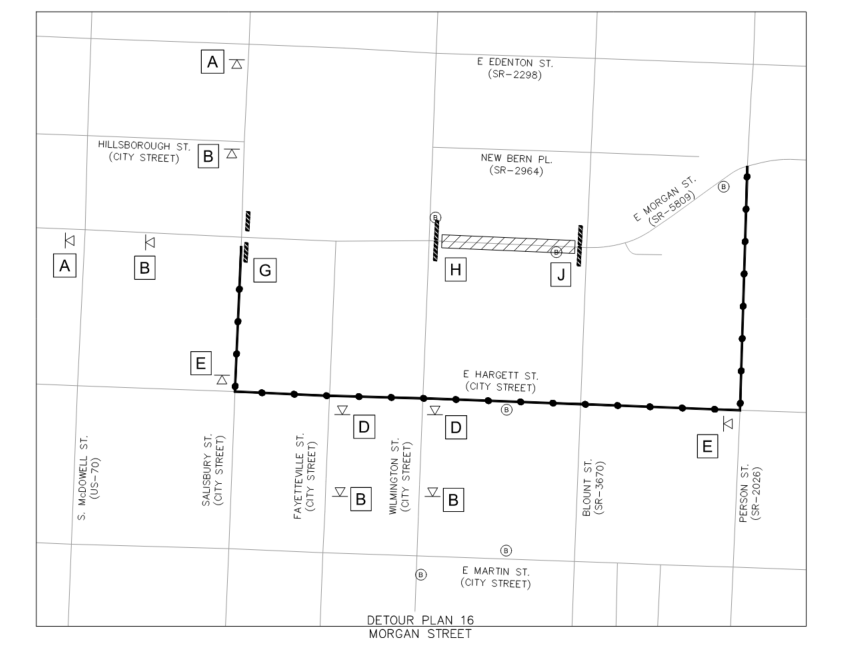

Detour Information

For eastbound traffic on E Martin Street:

  • Turn left onto S Wilmington Street
  • Turn right onto E Hargett Street
  • Turn right onto Blount Street
  • Turn left back onto E Martin Street

For westbound traffic on E Martin Street:

  • Turn left onto Blount Street
  • Turn right onto W Davie Street
  • Turn right onto S Wilmington Street
  • Turn left back onto E Martin Street

Thank you for your patience and cooperation as we work to improve our city’s streets! If you travel through downtown during these hours, please allow a little extra time and follow posted detour signs.

Completed Streets

Morgan Street
E. Edenton Street


Current Impacts

None

To Be Completed


2026 Work Schedule

Street Name Work Hours Duration Estimated Dates
East Martin Street Nights 7:00 PM - 6:00 AM 4-5 Nights 1/4/26 - 1/9/26
New Bern Place Days 9:00AM - 4:00 PM 1 Month 1/12/26 - 2/13/2026
Wilmington Street Nights 7:00 PM - 6:00 AM 4 Months 2/15/2026 - 5/14/2026

All street impacts and work schedules are subject to change due to weather and other unforeseen events.

Phase 3A is one part of a larger, multi-phase project to upgrade water and sewer infrastructure across Raleigh. Future phases will continue improvements in other parts of the city.

Project Details


Type:
Water and Sewer
Budget:
$10,000,000
Project Lead:
Todd Toler, Senior Engineer
Contractors:
Moffat Pipe, Inc.

Contact



Todd Toler
Senior Engineer
Phone: 919-996-3476
Office Location: 1 Exchange Plaza Suite 620
Raleigh, NC 27601

Contractor Project Manager:
Michael Tyler
Phone: 919-631-9814

Senior Project Manager:
Moffat Pipe
Brad Keeley
Phone: 919-710-5407

Raleigh Water On-site Inspector:
Kevin Radford
Phone: 919-795-0140


Lead Department:
Water
Participating Department:
Water
Service Unit:
Water and Sewer Development Review

Subscribe



Planning

Complete

Lead Department:
Water

Design

Complete

Lead Department:
Water

Construction

Moffat Pipe, Inc. began construction on June 9, 2025. The work includes replacing or rehabilitating about 3,700 feet of water lines, 6,100 feet of sewer mains, and 27 sewer manholes.

Weekly Update: The contractor is set to come back to this project in mid-November. When they return, crews will work for three days on Martin Street before proceeding to New Bern Place, where they will keep working until the end of December 2025.

The contractor has completed the sanitary sewer lining work and has temporarily transitioned to an alternate project. They will return to continue work in Downtown as scheduled.

Lead Department:
Water

Complete

Check back for future details.

Lead Department:
Water

Schedule

Project StageDate
Project Design CompleteSummer 2024
Permitting CompleteFall 2024
Easement Acquisition CompleteFall 2024
Project Bid CompleteFall 2024
Project Construction BeginsSummer 2025
Project Construction CompleteSummer 2026
