Western BRT

Transportation

Wake BRT: Western Design and Construction

Connecting Raleigh and Cary with frequent and reliable transit

Western Corridor

The Wake BRT: Western Corridor will connect downtown Raleigh to downtown Cary.

In November 2016, Wake County Voters approved a plan for focused investment in public transit which puts the implementation of the Wake County Transit Plan in motion. The plan calls for building approximately 20 miles of transit lanes along four (4) BRT corridors within Wake County (Wake BRT).

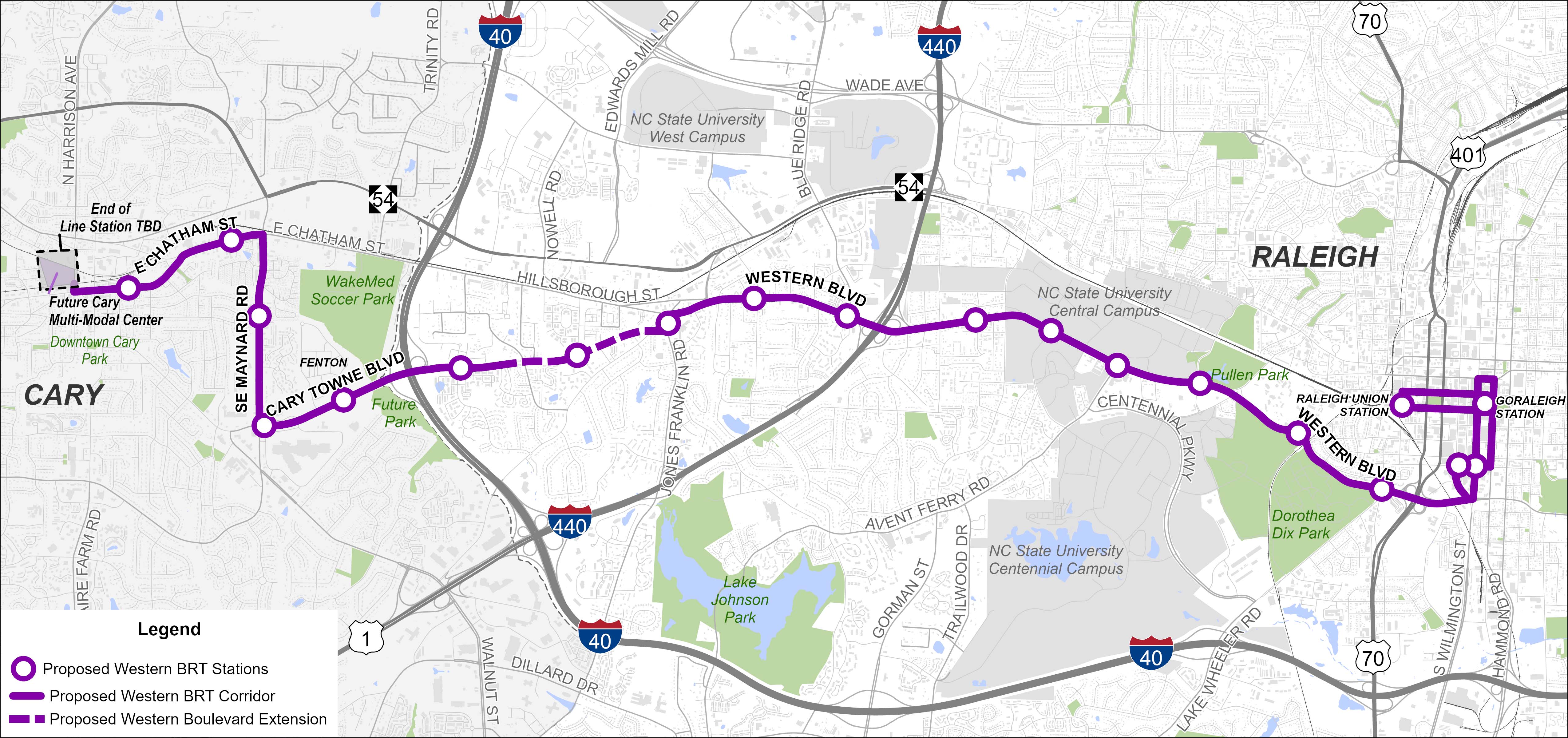

Western BRT Map

Project Details


Type:
Transportation Improvements
Project Lead:
Transportation - Transit Division
Contractors:
Kimley-Horn, HDR

Contact



Planning Project Manager
Gabriel Wilkins
gabriel.wilkins@raleighnc.gov

Contact Gabriel with any planning and design questions about Western BRT.

Engineering Project Manager
Ben Henderson
ben.henderson@raleighnc.gov

Contact Ben with any engineering and construction questions about Western BRT.

Lead Department:
Transportation
Participating Department:
Planning and DevelopmentEngineering Services
Service Unit:
Public Transportation

Subscribe



Planning

Project Overview

The Wake BRT: Western Corridor will connect downtown Raleigh to downtown Cary. The Western corridor is approximately 12 miles. It is proposed to operate in both dedicated transit lanes and mixed traffic between GoRaleigh station in downtown Raleigh and downtown Cary.



In 2016, the Wake Transit Plan identified four BRT corridors for implementation. The Western Corridor connecting downtown Raleigh and downtown Cary was one of the corridors identified. The Western Corridor was further evaluated in the Wake Transit Plan Major Investment Study (MIS) completed in 2018.



Studies & Decisions



Planning Phase began in The Western Corridor in 2019 with the Western Boulevard Corridor Study and completed in Summer of 2022 and approved by Raleigh City Council June 7, 2022. The study analyzed the land use capacity and urban form of the corridor to develop a conceptual land use plan as well as recommended a locally preferred route for the BRT. View the Western Boulevard Corridor Study Final Report, and visit the project page to learn about the Corridor Study.

Phase Contacts



Dhanya Sandeep

Planning Supervisor

Planning and Development

919-996-2659

Dhanya.Sandeep@raleighnc.gov

Lead Department:
Planning and Development

Design

  • The preliminary design phase (0 to 30 percent) for the Western Corridor BRT has been completed. The corridor is approximately 12 miles and will operate in both dedicated transit lanes and mixed traffic between GoRaleigh station in downtown Raleigh and downtown Cary.
  • Final 30% designs are nearing completion, and public engagement will restart upon their completion.

Current Activity

  • Continue coordination with Town of Cary, NC State University, and NCDOT about their overlapping projects along the corridor.
  • Obtain public feedback on 30% designs, which include roadway design, traffic pattern and signal updates, stormwater engineering, and station locations.
  • Continue coordination with Federal Transit Administration through the Capital Investment Grant process.
    • The Western Corridor Project was submitted to the Federal Transit Administration’s (FTA) Capital Investment Grant (CIG) program in Fall 2024. The project received a Medium-High rating - which shows a high likelihood of receiving federal funds in the future - when FTA published their Annual Funding Recommendations on November 13, 2025.
  • Continue environmental documentation as required by the National Environmental Policy Act (NEPA). We anticipate completing this work in Summer 2027.

Next Steps



Once we have received feedback on the 30% designs, we will then continue toward 60% designs which prepares us to begin talking to property owners about acquiring the land needed to build the project.

The 60% designs will also be what we use to refine our construction cost estimate. Having that is necessary before we finalize a grant agreement with the FTA.

Phase Contacts



Melanie Rausch
BRT Program Manager
melanie.rausch@raleighnc.gov
919-996-2291

Gabriel Wilkins
Senior Transit Planner
gabriel.wilkins@raleighnc.gov

Lead Department:
Transportation

Construction

Phase details coming soon.

Lead Department:
Engineering Services

Schedule

DateEvent
2018Wake Transit Plan Major Investment Study
2019Western Boulevard Corridor Study Begins
Fall 2020Western Corridor Locally Preferred Alternative (LPA) Selected
Fall 2020/Spring 2021Virtual Engagement
Winter 20200–30% Design Begins
Summer 2022Western Boulevard Corridor Study Complete
Fall 2022Public Engagement
Fall 2024Federal Small Starts Application. submitted
Fall 2024Preliminary 30% Designs Complete
Fall 2026Anticipated Final 30% Designs Complete
Summer 2027Anticipated NEPA completion
2030Anticipated start of construction
2032Anticipated start of operation

Engagement

The 30% design phase is complete, and we are currently bringing the designs to the public for feedback.  Please refer to this page for information on our survey and open houses, as well as links to the design maps.
Once public engagement is complete, we will post a summary of the results here.
